Dear reader, We need your support to keep the flame of knowledge burning bright! Our hosting server bill is due on June 1st, and without your help, Bharatpedia faces the risk of shutdown. We've come a long way together in exploring and celebrating our rich heritage. Now, let's unite to ensure Bharatpedia continues to be a beacon of knowledge for generations to come. Every contribution, big or small, makes a difference. Together, let's preserve and share the essence of Bharat.

Thank you for being part of the Bharatpedia family!
Please scan the QR code on the right click here to donate.

0%



transparency: ₹0 raised out of ₹100,000 (0 supporter)


Navi Mumbai Metro
Overview
Native nameनवी मुंबई मेट्रो
OwnerCity and Industrial Development Corporation (CIDCO)
LocaleNavi Mumbai, Maharashtra, India
Transit typeRapid Transit
Number of lines1
Number of stations20
HeadquartersCIDCO Bhavan, Sion Panvel Highway, CBD Belapur, Navi Mumbai
Operation
Operation will start2022 (expected)
CharacterElevated
Train length3 coaches
Technical
System length23.40 km (14.54 mi)
Track gauge1,435 mm (4 ft 8+12 in) standard gauge
Electrification25 kV, 50 Hz AC Overhead catenary
System map

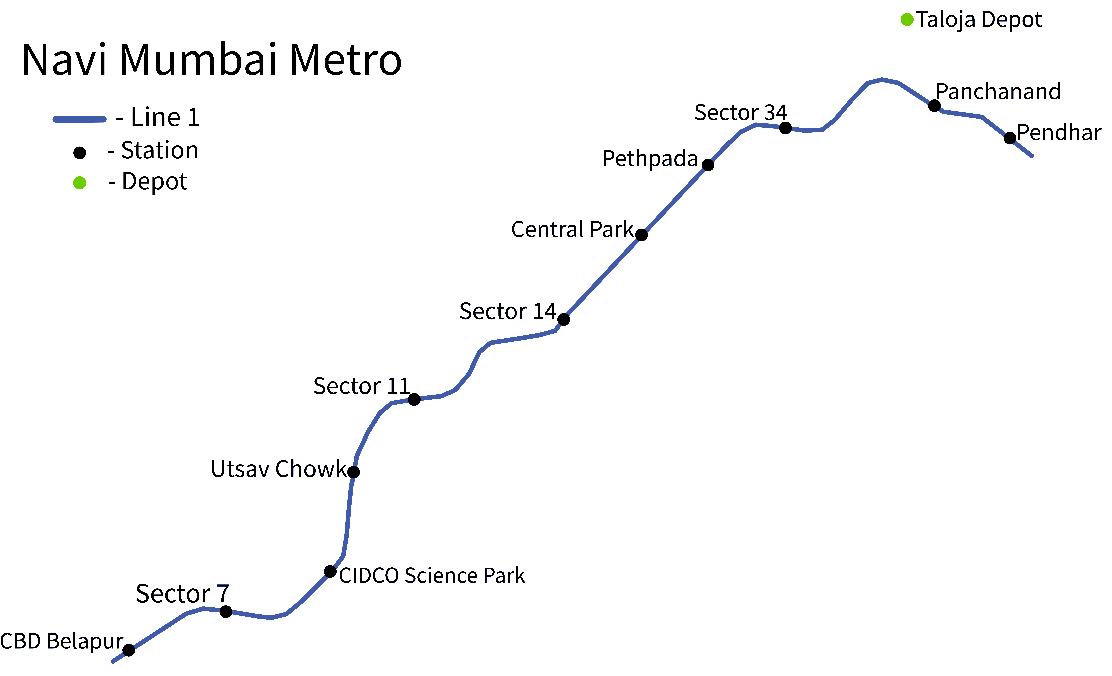

Navi Mumbai Metro Map.png

The Navi Mumbai Metro is a rapid transit system under construction in the Indian city of Navi Mumbai, Maharashtra. The planning and construction of the Navi Mumbai Metro is being overseen by the City and Industrial Development Corporation (CIDCO). The system is planned to consist of three rail lines covering a total distance of 106.4 kilometres (66.1 mi).[1] The foundation stone for the project was laid on 1 May 2011;[2] following construction delays, the metro's first line was projected to open in 2020.[3][4] However, due to the ongoing COVID-19 pandemic, which caused lockdowns, curfews, and lack of labour, which resulted in several delays in construction, the deadline is pushed to 2022 for completion of the first line (Line 1) of Navi Mumbai Metro. The metro's technological infrastructure and rolling stock are being provided by Ansaldo STS, Tata Projects and CSR Zhuzhou.[5]

History[edit]

The Navi Mumbai Metro projects received formal approval on 29 April 2010, and a public hearing on 21 May 2010 reported no major objections to the plan.[6] CIDCO was named as the implementing agency of the Belapur–Pendhar–Kalamboli–Khandeshwar line, under the Indian Tramway Act 1886, by the Government of Maharashtra on 30 September 2010.[1][7] The metro's foundation stone was laid on 1 May 2011 by Chief Minister Prithviraj Chavan, and general foundation work on the system's first phase commenced in October 2011.[2] In March 2012, CIDCO released the metro's complete master plan, including a proposed connection to the Mumbai Metro.[7] In February 2017, RITES submitted an interim detailed project report (DPR) for Lines II, III and IV of the Navi Mumbai Metro.[8]

In February 2013, thousands of villagers in the Navi Mumbai area protested against CIDCO's inaction on local housing developments and its failure to provide restitution for locals affected by infrastructure projects. The protesters pledged to "shut down the CIDCO head office and all development projects in the region. These will include the metro project and any progress on the airport project".[9]

Network[edit]

The Navi Mumbai Metro is planned to consist of five lines, totaling 106.4 kilometres (66.1 mi) in length.[1] As of 2017, Line 1 of the metro is under construction, with operation projected to commence in 2022.

Line 1[edit]

All the phases of Line 1 will be constructed and funded by CIDCO. Lines 2 and 3 will be funded by the Navi Mumbai Municipal Corporation and Mumbai Metropolitan Region Development Authority respectively. The total cost of Line 1 is estimated to be 4,068 crore (US$570 million).[1]

Construction[edit]

The 23.40-kilometre (14.54 mi) Line 1 consists of 20 stations. The proposed route will link CBD Belapur, Kharghar, Taloja, Taloja MIDC, Kalamboli, Kamothe and the Khandeshwar railway station, terminating at the proposed Navi Mumbai International Airport.[6]

In mid-2012, CIDCO awarded the 321 crore (US$45 million) contract for the construction of the 11.1 km section from Belapur to Pendhar to a consortium of Sanjose (Spain), Mahavira Road and Infrastructure (Navi Mumbai), and Supreme Infrastructure (Mumbai). The original deadline to complete the project was in 2016. This was later extended to mid-2017, and then mid-2018. By January 2017, only 60% of the work on the stations had been completed. Finding the progress of work to be unsatisfactory, CIDCO sent a notice terminating the contract to the consortium on 11 January 2017.[10] On 1 March 2017, CIDCO floated new tenders to construct 11 stations along the Belapur-Pendhar section. The previous contractors had completed 60% of the work on the stations. The new contract with worth 141 crore (US$20 million).[11]

Line 1 is planned to be developed in 3 phases:[1]

Line 1
Phase Terminal Length Stations Cost
I Belapur-Kharghar-Taloja-Pendhar 11.10 kilometres (6.90 mi) 11 1,985 crore (US$280 million)
II MIDC Taloja-Kalamboli–Khandeshwar
(extension to Airport proposed)
10.30 kilometres (6.40 mi) 8 1,509 crore (US$210 million)
III Interlink between Pendhar and MIDC 2 kilometres (1.2 mi) 1 574 crore (US$80 million)
Total 23.40 kilometres (14.54 mi) 20 4,068 crore (US$570 million)

Infrastructure[edit]

An international consortium of companies including Ansaldo STS, Tata Projects and CSR Zhuzhou will provide the electrical and mechanical systems for the first phase of Line 1. Ansaldo will conduct systems integration and supply train control systems, telecoms, fare collection systems and equipment storage.[5] The metro's standard gauge network would be electrified at 25 kV AC, with power provided via an overhead catenary.[5]

Rolling stock[edit]

In 2014, the Chinese company CSR Zhuzhou signed a contract with CIDCO to supply rolling stock for the first phase of the metro's Line 1.[5] The three-car trainsets would be 64.6 metres (212 ft) long and 3.1 metres (10 ft) wide, with a passenger capacity of around 1,100 and a maximum speed of approximately 80 kilometres per hour (50 mph).[12] The trains would feature stainless steel bodies, air-conditioning and LED lighting.[12][5]

Status Updates[edit]

  • Dec 2018: Work of elevated corridor almost complete, 50% work on signalling is done and 68% station related work in done.[13]
  • Mar 2019: Two sets of much-awaited 3- coach metro train for Navi Mumbai Metro arrived at Mumbai Port from China.[14]
  • Aug 2019: Metro trial run between Panchanand to Pendhar of Line-1 to start from 5 September. Line 1 is expected to be fully operational by mid-2020.[15]
  • Sep 2019: Between Panchanand and Pendhar metro line of 11 km, 83% work done on station, some track laying done. Trial run started on 3 km of track which is ready. Stations to be ready by December 2019. Full trial run on 11 km of track to start in January 2020.[16]
  • Sep 2020: Due to COVID-19 pandemic, which caused lockdowns, curfews and lack of labour in construction, City and Industrial Development Corporation (CIDCO) pushes deadline for completion of Navi Mumbai Metro Project to 2024.[17]
  • Sep 2020: Construction work resumed.[18]
  • Jan 2021: MahaMetro to complete Navi Mumbai Metro's Line 1.[19]
  • Apr 2021: Tenders invited for Navi Mumbai Metro construction of balanced works for Line 1.[20]
  • May 2021: City and Industrial Development Corporation (CIDCO) successfully completes first trial run of Navi Mumbai Metro from Kharghar Metro Station to Taloja Depot.[21]
  • Jun 2021: Bids invited for Access Control System at 11 elevated stations of Navi Mumbai Metro's Line 1.[22]
  • Jul 2021: MahaMetro to operate and maintain Navi Mumbai Metro's Line 1.[23]
  • Aug 2021: Trial run of Navi Mumbai Metro's entire Line 1 from Central Park Metro Station to Pendhar Metro Station will be conducted by Research Design and Standard Organization (RDSO) on 28 August.[24]
  • Aug 2021: Research Design and Standard Organization (RDSO) successfully conducts trial run of Navi Mumbai Metro from central park Metro Station to Pendhar Metro Station, and begins Oscillation Trial and Emergency Braking Distance (EBD) trial of the metro, which is to be conducted in two phases, in which the purpose is to test the dynamic behaviour of the rolling stock in different conditions, with regard to safety, stability and quality rides. These two trials will continue till mid-September, as of 31 August.[25]
  • Sep 2021: Research Design and Standard Organization (RDSO) successfully conducts Oscillation Trial and Emergency Braking Distance (EBD) trial of the metro.[26] City and Industrial Development Corporation (CIDCO) confirms partial opening of the metro by December.[27]
  • Oct 2021: The stretch of Line-1 of Navi Mumbai Metro from Pendhar to Central Park in Kharghar will be opened by December.[28]
  • Nov 2021: Navi Mumbai Metro gets Interim Speed Certificate from RDSO for Line-1.[29]

Gallery[edit]

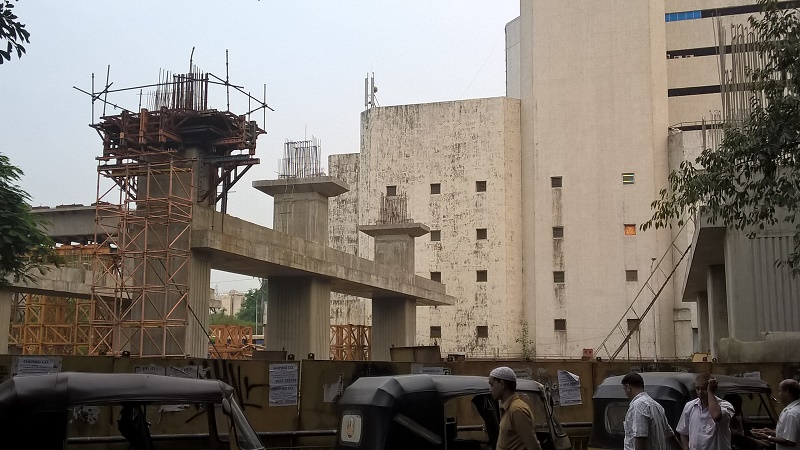

Some images of the under-construction Belapur Terminal Station.

See also[edit]

References[edit]

  1. 1.0 1.1 1.2 1.3 1.4 "Introduction". CIDCO. 2012. Retrieved 3 July 2014.
  2. 2.0 2.1 "Work on first phase of Navi Mumbai Metro Rail begins". The Economic Times. 28 October 2011. Retrieved 30 October 2011.
  3. "Navi Mumbai Metro misses deadline, may start operations by 2017". The Times of India. 6 July 2014. Retrieved 1 November 2014.
  4. "Next metro only by 2016 - Mumbai - DNA". DNA India. Retrieved 28 September 2013.
  5. 5.0 5.1 5.2 5.3 5.4 "Navi Mumbai metro E&M contract awarded". Railway Gazette. 24 July 2014. Retrieved 25 February 2015.
  6. 6.0 6.1 "Neither objections nor any suggestions for metro project | Mumbai, World Snap". Worldsnap.com. 2010. Archived from the original on 14 July 2010. Retrieved 31 August 2010.
  7. 7.0 7.1 "Cidco takes Navi Mumbai metro plan ahead". DNA India. 27 March 2012. Retrieved 5 April 2012.
  8. "Cidco studying interim report on 3 lines of Metro project - Times of India". The Times of India. Retrieved 15 February 2017.
  9. "Massive agitation by Navi Mumbai villagers from today". Hindustan Times. 11 February 2013. Archived from the original on 12 February 2013. Retrieved 12 February 2013.
  10. "Cidco mulls terminating line 1 Metro contract - Times of India". The Times of India. Retrieved 3 March 2017.
  11. "Push for Navi Mumbai Metro, maiden run likely by May 2018 - Times of India". The Times of India. Retrieved 3 March 2017.
  12. 12.0 12.1 "CIDCO opts for wider metro coaches". Mid-Day. Mid-Day Infomedia Ltd. 26 February 2012. Retrieved 5 April 2012.
  13. https://www.mid-day.com/articles/navi-mumbai-metro-brings-howrah-bridge-to-mumbai/20060159
  14. "Sleek, swank, smooth: New trains arrive for Navi Mumbai metro". mid-day. 11 March 2019. Retrieved 11 March 2019.
  15. https://urbantransportnews.com/navi-mumbai-metro-to-start-trial-test-run-from-september-5/
  16. https://www.hindustantimes.com/mumbai-news/navi-mumbai-metro-inches-closer-to-reality/story-OClAbaYSR2ujjTaInCnv4I.html
  17. Sep 15, SANJAY BANERJEE / TNN /; 2020; Ist, 14:03. "Navi Mumbai: Cidco Metro back on track, deadline pushed to 2024 | Navi Mumbai News - Times of India". The Times of India. Retrieved 7 September 2021.{{cite web}}: CS1 maint: numeric names: authors list (link)
  18. Sep 15, SANJAY BANERJEE / TNN /; 2020; Ist, 14:03. "Navi Mumbai: Cidco Metro back on track, deadline pushed to 2024 | Navi Mumbai News - Times of India". The Times of India. Retrieved 7 September 2021.{{cite web}}: CS1 maint: numeric names: authors list (link)
  19. Jan 29, Ashish Roy / TNN /; 2021; Ist, 04:23. "MahaMetro to complete Navi Mumbai Metro Line 1 | Nagpur News - Times of India". The Times of India. Retrieved 7 September 2021.{{cite web}}: CS1 maint: numeric names: authors list (link)
  20. Shah, Narendra (12 April 2021). "Tenders invited for Navi Mumbai Metro construction of balance works for Line-1". Metro Rail News. Retrieved 7 September 2021.
  21. Shah, Narendra (7 May 2021). "CIDCO conducts trial run on Navi Mumbai Metro line 1". Metro Rail News. Retrieved 7 September 2021.
  22. Shah, Narendra (12 June 2021). "Bids invited for Access Control System at 11 elevated stations of Navi Mumbai Metro Line-1". Metro Rail News. Retrieved 7 September 2021.
  23. "Maha-Metro to operate and maintain Line 1 of Navi Mumbai Metro project". The Indian Express. 16 July 2021. Retrieved 7 September 2021.
  24. Khanna, Rajat (26 August 2021). "Tremble trial of Navi Mumbai Metro Line 1 project will start from 28th August 2021". Metro Rail News. Retrieved 7 September 2021.
  25. "RDSO starts oscillation trial of Navi Mumbai Metro, likely to continue till mid-September". Free Press Journal. Retrieved 7 September 2021.
  26. "Oscillation trials of Navi Mumbai Metro line 1 completed". The Indian Express. 16 September 2021. Retrieved 18 September 2021.
  27. "Partial opening of Navi Mumbai Metro by December: CIDCO chief". www.mid-day.com. Retrieved 18 September 2021.
  28. "Part of Navi Mumbai Metro Line 1 between Central Park in Kharghar and Pendhar can start operations in Dec 2021". Hindustan Times. 8 October 2021. Retrieved 10 October 2021.
  29. "Navi Mumbai Metro gets Interim Speed Certificate for first route". Hindustan Times. 22 October 2021. Retrieved 8 November 2021.

Template:Maharashtra transit
